Supply chain risk management plan: owners, triggers and tested actions

Turn a risk register into executable supplier responses with owners, qualification status, customer communication and closure evidence.

What is a supply chain risk management plan?

A supply chain risk management plan defines how your team detects, reduces, and responds to supply interruptions that threaten production. It connects critical parts and sites to warning signals, named owners, approved recovery options, customer communication, and evidence of completion. A risk register identifies exposure; the plan specifies what happens next.

The result is a response the team can execute before usable stock runs out. It supports Resilience by turning assessments into funded actions, and it gives purchasing, planning, quality, and finance one record of who must do what. Start with your own builds and customers, then attach the applicable contract and certification requirements.

What scope should the plan cover?

Define the products, production sites, suppliers, upstream processes, and customer commitments covered by the plan. Include the parts that can stop a build and the dependencies needed to produce them. Document exclusions and interfaces with other plans, so a supplier disruption does not fall between purchasing's continuity plan and the site's emergency response.

For a discrete manufacturer, start with material supply, qualified sources, outside processing, critical tooling, transport, inspection, and evidence needed to release stock. Internal facilities and workforce risks may sit in a separate continuity plan, but your supplier plan should identify who owns that interface. An unavailable receiving function can make a recovered shipment unusable for the build.

List customer requirements separately from your recommended operating practices. An automotive customer may require contingency tests and notification through its own portal. Another customer may need approval before a source or process changes. Record which requirement applies to which part or program rather than putting every customer rule on every supplier.

How do you turn a risk register into a plan?

For each critical risk, define a measurable trigger, a decision owner, a response, and the evidence needed to finish it. Add the time available before the first affected build and the lead time for recovery. A mitigation that takes longer than your protection needs an interim action or an explicit acceptance of the remaining exposure.

Start with the supplier risk assessment. Rewrite vague risks as scenarios somebody can act on. “Capacity risk” becomes “the only approved heat-treatment site cannot complete the next lot by its latest release date.” “Financial risk” becomes “the material vendor's credit hold prevents the casting purchase needed for the next build.”

For each scenario, name both a risk owner and an action owner. The risk owner keeps the exposure current and escalates decisions. The action owner delivers a specific result, such as approval of an alternate process or confirmation of a lot's release. The same person can hold both roles, but the work and completion test should remain clear.

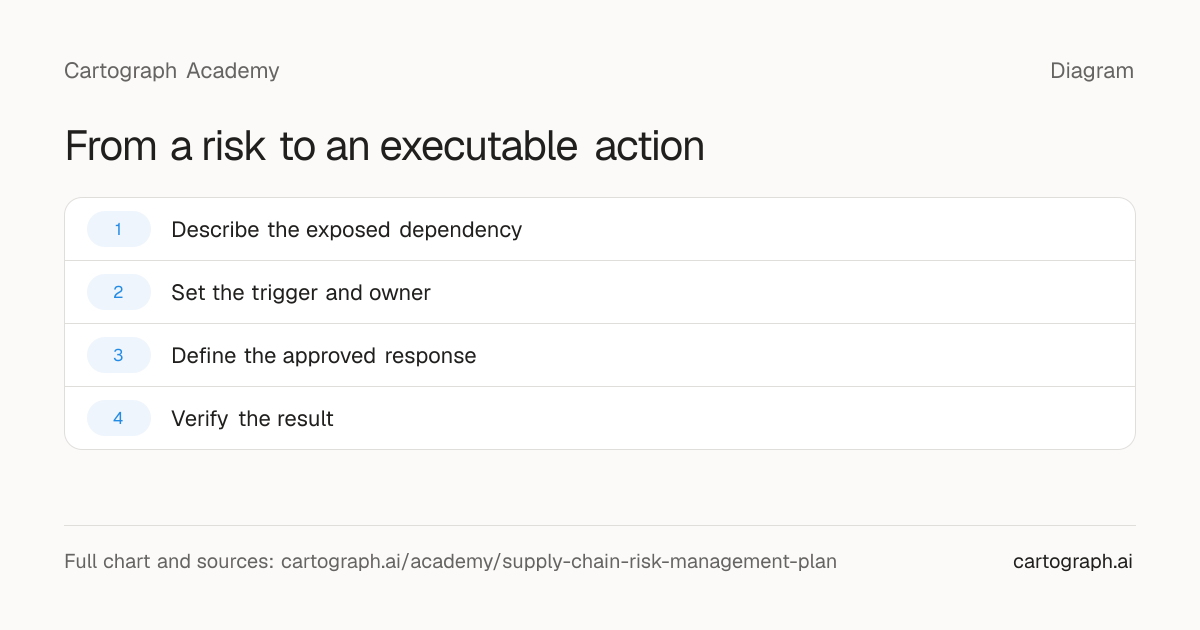

From a risk to an executable action

An illustrative four-step supply risk action record starts with a delayed casting-release scenario, identifies an observable trigger and the purchasing owner, defines qualification and interim protection work, and closes only when documented approval and usable supply evidence exist. The record uses no fixed legal deadline or promised recovery duration.

  1. 1

    Describe the exposed dependency

    Record to keep
    Casting release misses the latest date needed for the next kit
  2. 2

    Set the trigger and owner

    Record to keep
    Buyer checks the release milestone; planning identifies affected builds
  3. 3

    Define the approved response

    Record to keep
    Quality confirms alternate approval work; purchasing checks interim supply
  4. 4

    Verify the result

    Record to keep
    Save approval and usable-supply evidence; update remaining exposure

Suggested action record: define the failure, trigger, response and evidence that closes it.

The example is an operating template, not a prescribed form. Copy its structure and use your own dates, contacts, customer approvals, and acceptance criteria. Link supporting evidence rather than burying drawings or confidential accounts in a widely shared spreadsheet.

What makes a recovery option executable?

An executable option has a qualified source, available capacity, required technical information, authorized commercial terms, and a credible date for usable parts. List what remains unfinished. “Second supplier identified” is not a recovery capability when first article, customer approval, tooling, or material procurement would start only after the primary source fails.

Distinguish stages: candidate identified, capability checked, quotation received, qualification underway, approved, and able to deliver. Keep the actual remaining tasks and owner beside each stage. For a source that is approved but has no capacity, the approval alone does not protect the schedule.

Compare the full replacement path with usable stock. Include shipment and receiving time, required certifications, and inspection. If inventory covers only the beginning of that path, decide whether to carry more protection, qualify earlier, or agree another recovery route. Clear-to-build explains why stock under inspection or on hold cannot simply be counted as protection.

Check whether two alternatives depend on the same upstream operation. A second machine shop using the original foundry may leave the main exposure intact. Test that assumption before declaring dual sourcing complete.

What do automotive contingency requirements add?

For organizations to which IATF 16949 applies, contingency planning includes supply interruptions and other continuity threats, customer notification, periodic effectiveness tests, and at least annual multidisciplinary review with top management. The plan also needs revision records and employee awareness. These are certification requirements within their scope, not requirements imposed on every manufacturing business.

IATF's public Sanctioned Interpretation 3 covers supplier interruptions, equipment failure, disasters, fire, pandemics, utility loss, cyber-attacks, labor shortages, and infrastructure disruption. It also requires provisions to validate product conformity after an emergency production restart when normal shutdown processes were not followed. IATF 16949, SI 3, clause 6.1.2.3.

Map applicable customer-specific requirements into the plan and use the current standard together with its sanctioned interpretations. The supplier continuity plan may cover only part of the organization's required contingency arrangements. Do not describe it as the entire certification response when facilities, personnel, or information systems are managed elsewhere.

How should you test the plan?

Test a specific failure scenario with the people who would respond, and record whether the proposed actions work within the available time. Start with a tabletop exercise, then verify the important dependencies. A rehearsal that only confirms everyone attended does not show that alternate parts can arrive, be accepted, and support production.

Give the team a concrete event: the primary supplier cannot release its next casting lot, and the next kit depends on that lot. Ask purchasing to contact the recovery source using stored details. Ask quality to identify the missing approval. Ask planning to calculate the exposed builds. Ask the customer owner to draft the required notification.

Record what failed: an obsolete contact, an assumed approval, a tool at the wrong site, or a replenishment time that excludes inspection. Assign corrections and retest the part that failed. Use a risk-based test schedule; any certification or customer requirement sets additional constraints.

IATF FAQ 29 explains that effective contingency planning needs evidence of review, regular testing and validation, and compliance with customer requirements. Its examples include auxiliary sources, contracted services, and safety stock; none substitutes for checking whether your chosen response works. IATF FAQ 29.

In the United States

As checked September 26, 2026, EO 14415 §3(c) directs proposed regulations to require mitigation, action tracking to closure, notification, corrective-action plans, and closeout reports after supplier vetting. Keep these future implementing requirements distinct from obligations already in your contract; the order alone does not make the same reporting schedule apply to every supplier today. EO 14415 §3(c).

Selling into the EU?

For entities within NIS2's scope, Article 21 includes business continuity, crisis management, supply-chain security, and assessment of cybersecurity measures' effectiveness. Coordinate supplier-cyber response with the organization's applicable national requirements and incident process. This is a cybersecurity obligation for covered entities, not a universal physical-supply contingency standard. Directive (EU) 2022/2555, Article 21. Checked September 26, 2026.

How do you keep mitigation actions from becoming stale?

Review open actions against their due dates and the evidence that would close them. Refresh the plan when ownership, demand, process, site, or recovery assumptions change. Preserve decisions and revisions. An annual sign-off can confirm governance, but it cannot replace checking a time-sensitive mitigation when the next build depends on it.

Put unresolved supplier requests in a dated queue. Follow up with the authorized contact, record the response, and escalate missing information to the decision owner. Keep commercial promises separate from qualification evidence. A supplier's confirmation that it “can help” is not the same as approval to ship your specific revision.

Use purchase order tracking for delivery milestones and supplier financial risk for changes in funding. Those operating signals should update the plan when they invalidate an assumption, not generate a disconnected second register.

What should your plan review checklist contain?

Review the plan for usable decisions, current dependencies, tested responses, and accountable owners. A reader should be able to identify the first exposed build, contact the right people, and find the approved action without reconstructing the assessment. Keep evidence of tests, revisions, acceptance of residual risk, and closure together with the plan.

  • Scope identifies the products, sites, suppliers, and interfaces covered
  • Critical parts have dated evidence and a defined failure scenario
  • Triggers name an observable event and the person who checks it
  • Actions have an owner, due date, funding decision, and closure test
  • Alternate-source status lists every unfinished approval and constraint
  • Inventory protection uses available material and realistic demand
  • Customer communication identifies the contact and applicable requirement
  • Tests record results, gaps, corrections, and any needed retest
  • Revisions record who approved them and why assumptions changed

What questions do teams ask about supply chain risk plans?

A plan needs to work for the team using it and meet the requirements that actually apply. Keep its working register, formal review, and customer obligations connected. These answers clarify what a register contributes, what a template cannot establish, and how operating reviews fit alongside certification or customer requirements.

Is a risk register a supply chain risk management plan?

A register records exposures and can hold the working data. It becomes a useful plan when it also specifies detection triggers, decisions, owners, response steps, and completion evidence. Keep the connection explicit: a high-risk label alone does not tell the buyer who should qualify a source or when the planner must change the build.

Does the plan guarantee an auditor will accept it?

No. Acceptance depends on the applicable standard, customer requirements, implementation, and evidence. Build the plan against those criteria, retain records of tests and corrections, and verify that people can execute it. A template can organize that work, but its title or a completed checklist cannot establish certification conformity by itself.

How often should we review it?

Follow applicable certification and customer requirements, then add reviews when assumptions change. IATF's contingency requirements include at least annual review; a critical supplier event may require action much sooner. Choose operating reviews that match the exposure and the time available to recover, and give unfinished actions their own follow-up dates between formal reviews.

If supplier evidence is the missing step in your response plan, talk to our team about the requests and follow-up your buyers need to complete.

This article is general information, not legal or tax advice. Check how the rules apply to your business with your legal or tax advisor.
