Dual sourcing: qualification, volume splits and risk

Keep builds running when one supplier stops. Qualify a second source, split volume so its approval stays current, and check for shared sub-tiers.

A second source keeps your build running when the first supplier stops shipping, but only if it is approved for production, independent of the first supplier's inputs, and current when you need it. Getting there means choosing the right sourcing approach, qualifying the second supplier, checking for shared sub-tiers, and splitting volume so the backup stays ready.

What is dual sourcing?

Dual sourcing means buying the same part from two suppliers that are each approved to ship production parts for it. Both suppliers receive orders, so each keeps its process running and its approval current. If one supplier stops shipping, the other can carry the build without a new qualification. Multi sourcing applies the same idea to three or more suppliers.

A supplier that quoted once, or passed an audit years ago, is only a candidate. A second source has passed first article inspection or PPAP at its current revision and has shipped production parts since. In electronics, "second source" can also mean an alternate manufacturer of an interchangeable component, and the alternate still needs approval before it's used.

A single-source part has one approved supplier by choice, while a sole-source part has only one supplier able to make it. Dual sourcing fixes the first case. A sole-source part needs a second capable supplier developed first, as the lesson on sole source vs single source explains.

When do single, dual and multi sourcing make sense?

Compare how long it would take to approve a new supplier with how long your inventory and open orders cover the build. When requalification takes longer than that cover, the part needs a second source that is already approved. When requalification is quick, a single source with a planned buffer can be enough.

ApproachFits whenWhat it costs
Single sourceRequalifying elsewhere is quicker than your buffer lasts, or volume is too low to splitExposure to one supplier's disruption
Dual sourceQualification is long (castings, forgings, special processes, regulated parts) and the part stops the buildA second qualification, often duplicate tooling, smaller orders to each supplier
Multi sourceMany suppliers make the part to one open specificationSupplier management effort and lot-to-lot variation

For a low-volume part, a split may leave each supplier too little work to keep its process running. A single source backed by safety stock and a documented emergency qualification plan can be the better choice.

In the United States

Executive Order 14415 was signed July 20, 2026. Section 4(c) gives the Secretary of War 90 days, to about October 18, 2026, to develop a strategy to speed up testing and qualification of new sources and materials at any tier, an agency deadline, not a contractor one. Section 4(a) gives the Secretary 180 days, to about January 16, 2027, to initiate regulatory action that identifies, in his sole discretion, existing acquisitions that support, implicate or relate to national security, and requires contractors on them that rely on an unreliable foreign supplier to qualify and use an alternative source as soon as possible, consistent with law, safety, mission requirements and existing contract requirements, unless none is available. Once those rules apply, failure to qualify that alternative is grounds for the Secretary to consider suspending or terminating task orders, declining options, or terminating the contract, consistent with law and contract terms. Section 7(f) defines an unreliable foreign supplier as any person under the foreign ownership, control or influence of a covered nation in 10 U.S.C. 4872(f)(2) (North Korea, China, Russia and Iran) or of a nation the Secretary designates. EO 14415, Sections 4 and 7(f).

How do you qualify a second source?

Qualify the second source through the same approval path as the first, and keep the evidence from each step. The team evaluates the supplier, agrees the quote and tooling, and proves the part through first article inspection or PPAP. Only after approval does it go onto the approved supplier list, and its first production lot ships under closer inspection.

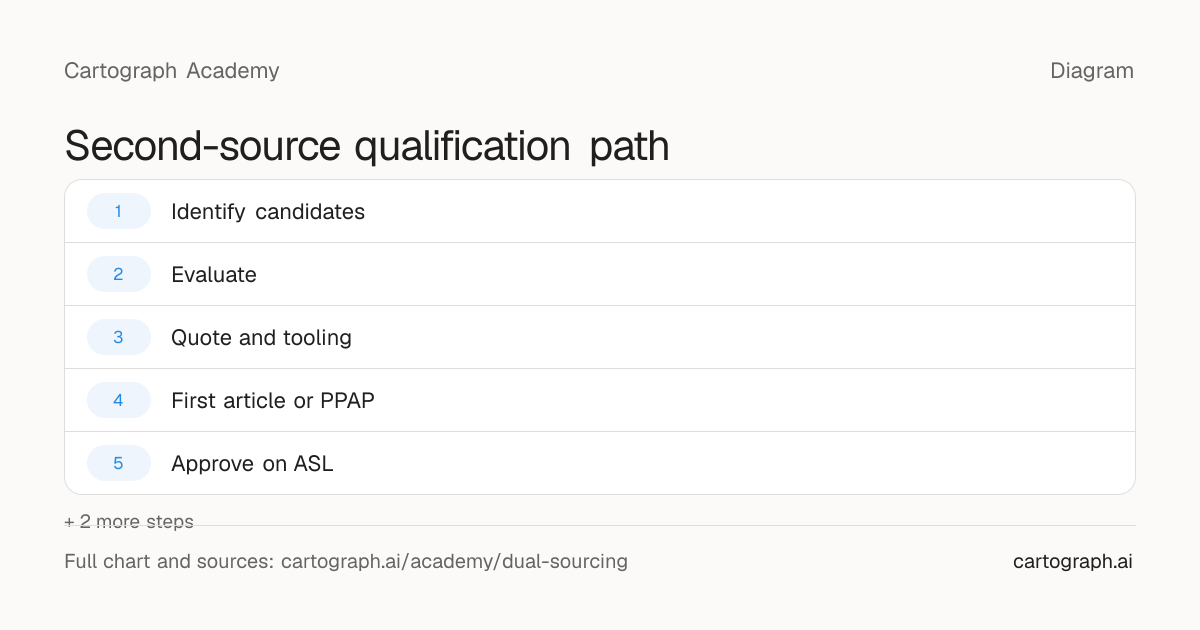

Second-source qualification path

A left-to-right flow of seven steps for qualifying a second source: identify candidates, evaluate the supplier, quote and tool, first article inspection or PPAP, approve on the approved supplier list, first production lot, and keep warm. Under each step a card lists the evidence to keep and the usual owner, and the last step loops back with the AS9102 two-year and PPAP 12-month requalification windows.

  1. 1

    Identify candidates

    What happens
    Find suppliers able to make the part to its current revision, and ask each to declare its sub-tier sources and sites
    Evidence to keep
    Candidate list with capability notes; sub-tier and site declarations compared against the incumbent's
    Usual owner
    Buyer
  2. 2

    Evaluate

    What happens
    Assess quality system, process capability, capacity, financial health and ownership
    Evidence to keep
    Survey or audit report; quality certifications; capacity statement; risk review
    Usual owner
    Supplier quality engineer
  3. 3

    Quote and tooling

    What happens
    Agree price, lead time, tooling ownership and the planned volume split
    Evidence to keep
    Quote; tooling order and ownership record; draft supply agreement with the split
    Usual owner
    Buyer
  4. 4

    First article or PPAP

    What happens
    Run parts on production tooling and process and verify every characteristic; check whether the customer or regulator must be told
    Evidence to keep
    AS9102 FAI report or PPAP submission and customer approval; 510(k) or notified-body change assessment for medical devices
    Usual owner
    Supplier quality engineer
  5. 5

    Approve on ASL

    What happens
    Add the supplier to the approved supplier list, scoped to part number, revision, site and special processes
    Evidence to keep
    ASL entry with scope and approval date
    Usual owner
    Quality
  6. 6

    First production

    What happens
    Ship the first production lot under closer receiving inspection
    Evidence to keep
    Receiving inspection records; certificate of conformance
    Usual owner
    Supplier quality engineer and receiving
  7. 7

    Keep warm

    What happens
    Place regular orders under the split, confirm dates and check status, and watch requalification windows
    Evidence to keep
    Order history; confirmations; last production date per part against the AS9102 two-year and PPAP 12-month windows
    Usual owner
    Buyer and planner

Each step leaves evidence, and the last step keeps the approval from lapsing.

Track each candidate's progress on a simple worksheet:

StepEvidenceOwnerStatus
First article or PPAPAS9102 FAI report, rev 4Supplier quality engineerIn review, due 2027-01-20

For the part itself, aerospace customers expect a first article inspection under AS9102, which lists a change in manufacturing source among its triggers. Automotive customers expect a PPAP submission from the new source (or, at German OEMs, a VDA 2 PPA). Scope the approval to the part number and revision, the manufacturing site and any special processes, because an approval at one site doesn't cover a sister plant.

In the United States

For medical devices, a new source can affect what FDA has cleared. Under 21 CFR 807.81(a)(3)(i), a new 510(k) is required when a change could significantly affect safety or effectiveness, including a significant change in material, chemical composition or manufacturing process. FDA's guidance treats a change in a supplier's material processing or finishing steps as a materials change. It asks manufacturers to analyze supplier changes through the quality system, even when the material stays within its original specification. FDA, Deciding When to Submit a 510(k) for a Change to an Existing Device (2017), Section C, question C2. Record the decision and rationale for each new source. A second source that keeps the same material, process and specification is less likely to need a new submission.

Selling into the EU?

Under the EU Medical Device Regulation, a manufacturer must inform the notified body that approved its quality management system of any plan for substantial changes to that system, and the notified body decides whether to audit further. Regulation (EU) 2017/745, Annex IX, Section 2.4. Where the notified body assessed the technical documentation, changes that could affect safety, performance or the conditions prescribed for use need its approval. Annex IX, Section 4.10. Neither section names supplier changes. MDCG guidance for legacy devices treats a new supplier of a material or component within the same specification as not a significant change in design or intended purpose for devices still on MDD or AIMDD certificates, but keeps it subject to the notification procedure agreed with the notified body. MDCG 2020-3 Rev.1, Section 4.2. Check your certificate conditions and that procedure before the second source ships.

How do you confirm the two sources are independent?

Two suppliers protect you only if they don't share a critical input. Ask each source to name the companies and sites behind its castings or forgings, dies and molds, raw material or resin grade, and special processes. Compare the two lists. A shared name means one event can stop both sources.

Shared sub-tier check

A supply map showing your part at the top fed by two approved tier-1 suppliers, Supplier A and Supplier B. Each tier-1 has its own heat treater, but lines from both tier-1s converge on the same casting house at tier 2, which is highlighted as a shared single point of failure. A side panel lists the inputs to compare for each source: castings or forgings, dies and molds, raw material or resin grade, special processes and ship-from region.

NodeTierFeedsShared between sources?
Your partEnd item——
Supplier A (machining)Tier 1Your partNo
Supplier B (machining)Tier 1Your partNo
Heat treater ATier 2Supplier ANo
Heat treater BTier 2Supplier BNo
Casting house X (same pattern and alloy)Tier 2Supplier A and Supplier BYes — single point of failure
Alloy producerTier 3Casting house XYes, through casting house X

Illustrative example: two approved suppliers that buy from one casting house give you one source of risk, not two.

Shared sub-tiers are easy to miss, because qualification looks only at the supplier in front of you. Two machine shops can each pass while both buy forgings from the same forge and die. A second source like that adds cost without removing the risk. The US Department of Defense has reported that, in the kinetic capabilities industrial base, which covers missiles, hypersonics and directed energy, prime contractors have lost some visibility into their sub-tiers, especially below the third tier. DoD, Securing Defense-Critical Supply Chains (February 2022), p. 14.

When the lists overlap, ask one source to qualify a different sub-tier supplier, qualify an alternate yourself, or hold a buffer of the shared input. Record the overlap as a known risk with an owner. Supply chain mapping keeps these lists current across parts.

How should you split volume to keep a second source qualified?

Give the second source regular orders, so its process stays inside requalification windows. AS9102 treats a two-year production lapse as a trigger for an FAI evaluation of the characteristics the inactivity may have affected. Customers that use AIAG PPAP require notification when tooling has been inactive for volume production for 12 months or more. A standing split avoids both.

IAQG guidance adds that after a lapse of two years or more, an FAI is required for any characteristics the inactivity may have affected, and the FAI procedure should document the rationale when a full FAI isn't performed. IAQG, 9102 Rev B FAQ (2015), B1. SAE AS9102C. AIAG PPAP, 4th edition, Section 3.1. Customer quality clauses can set their own windows, so check the purchase order.

Set the split in the supply agreement rather than order by order. The share needs to keep the part in the supplier's schedule, with trained operators and tooling. Ask each source how much volume it could take, and how fast, if the other stopped.

Small orders to the second source still need a confirmed date and a status check before they're due, because a slipped order stretches the gap since its last production run. Cartograph's readiness signals open a task when an order has no confirmed date and, by default, another task three days before the expected date, and Cartograph hands each task to your team or Scout Agent.

Selling into the EU?

German automotive customers usually apply VDA Volume 2 (6th edition, April 2020), the production process and product approval procedure (PPA, or PPF in German). VDA QMC, VDA Volume 2 PPF. Its trigger matrix sets out which changes need a new PPA, but a customer can replace it. Sumitomo Electric Bordnetze SE, PPA procedure of purchased parts (2024), pp. 3 and 5. Mercedes-Benz's special terms MBST 13 set their own list instead, including a change of second-tier supplier and a production stoppage of more than 12 months. Mercedes-Benz U.S. International, SQAM 28.01 (April 2023), Section 3.6. Read each customer's own trigger list.

Is dual sourcing worth the cost?

Compare the yearly cost of keeping the second source approved with what a stoppage would cost without one. That cost covers qualification, duplicate tooling, any price premium and supplier management time. The exposure is the gap between qualification time and buffer time, multiplied by the cost of each idle day.

Build the comparison from your own numbers. Engineering estimates qualification time, planning states the days of cover, and finance puts a daily figure on lost output and expediting. If qualification is shorter than the buffer, a single source may be right. Revisit it when a customer requirement, lead time or mapped sub-tier changes.

Questions teams ask

Is a backup supplier the same as a second source?

No. A backup that is approved but receives no orders drifts out of approval as production lapses. A second source ships production parts on a schedule, keeping its approval and process current.

Does a distributor count as a second source?

Only if it buys from a different manufacturer. A distributor reselling the same manufacturer's parts shares that manufacturer's risks with your direct source.

How much volume should the second source get?

There's no fixed rule. Give it enough to run inside every requalification window and stay in the supplier's schedule, and write the split into the supply agreement.

If you want orders to your second sources confirmed and checked without extra follow-up work, talk to our team.

This article is general information, not legal or tax advice. Check how the rules apply to your business with your legal or tax advisor.

Sources (12)
  1. Executive Order 14415, Sections 4 and 7(f)
  2. SAE AS9102C, Aerospace Series – First Article Inspection Requirements (2023)
  3. IAQG, 9102 Rev B FAQ (2015), B1
  4. AIAG PPAP, 4th edition, Section 3.1
  5. 21 CFR 807.81
  6. FDA, Deciding When to Submit a 510(k) for a Change to an Existing Device (2017)
  7. Regulation (EU) 2017/745 (MDR), Annex IX, Sections 2.4 and 4.10
  8. MDCG 2020-3 Rev.1 (May 2023), Section 4.2
  9. VDA QMC, VDA Volume 2 PPF, 6th edition, April 2020
  10. Mercedes-Benz U.S. International, SQAM 28.01 (April 2023), Section 3.6 (MBST 13 triggers)
  11. Sumitomo Electric Bordnetze SE, PPA procedure of purchased parts (2024)
  12. DoD, Securing Defense-Critical Supply Chains (February 2022)
