Supplier financial risk: warning signs before parts stop shipping
Check operational warning signs with finance, protect tooling records and connect cash concerns to the next exposed build.
What is supplier financial risk?
Supplier financial risk is the possibility that a supplier cannot fund the work needed to meet its obligations. For a manufacturer, the immediate exposure is interrupted material purchases, production, or shipment. Assess current cash pressures alongside financial statements, then connect that evidence to the parts, tooling, and builds you depend on.
The goal is to act while parts are still moving. Your team needs to distinguish a normal commercial negotiation from a change that threatens supply, protect evidence of assets it owns, and prepare a workable response. Financial continuity belongs to Resilience, with finance and purchasing sharing the assessment rather than leaving it to a credit score.
Which operating signals deserve attention?
Watch for sudden prepayment requests, shorter payment terms, material vendors withholding supply, repeated promise-date changes, or departures that leave critical work unsupported. Each signal needs verification; none alone proves insolvency. Ask what changed, what specific order is affected, and what must happen for the supplier to complete and ship it.
Compare the request with the supplier's history. A deposit for a new custom tool may be ordinary. An established supplier asking for cash before every shipment, after years of agreed credit terms, needs a closer discussion. Confirm that the request came from an authorized person and involves the correct entity and purchase orders.
Ask operational questions before debating a score. Is your raw material ordered? Has the outside processor accepted the job? Is the supplier waiting for payment before releasing completed parts? Can it explain the remaining operation and date? Keep allegations separate from confirmed facts. A comment from one employee about unpaid vendors is a reason to investigate, not a finding to circulate as established fact.

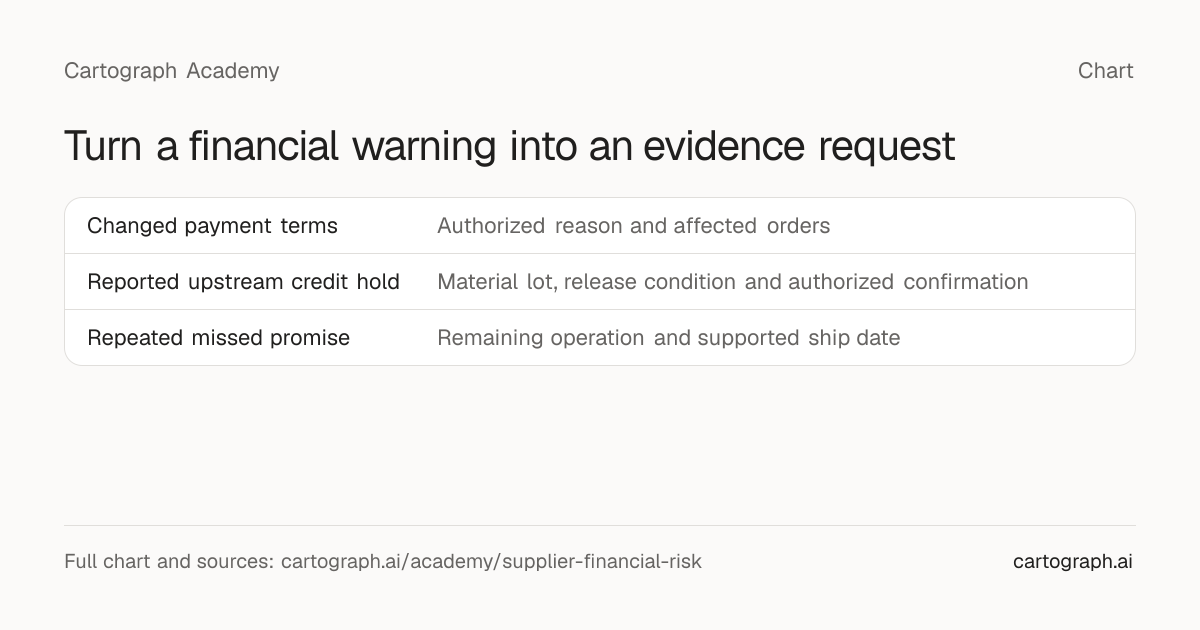

Turn a financial warning into an evidence request
A qualitative action tracker connects three possible supplier warning signals to information needed and an internal owner. Changed payment terms require an authorized explanation and finance review; a reported material hold requires order-specific release evidence; a missed promise requires a supported production and shipment date. None of the signals is labelled proof of insolvency.
| Signal | Evidence to request | Decision owner | Closure evidence |
|---|---|---|---|
| Changed payment terms | Authorized reason and affected orders | Finance and purchasing | Approved decision with a defined supply milestone |
| Reported upstream credit hold | Material lot, release condition and authorized confirmation | Purchasing and finance | Verified material release or approved alternative |
| Repeated missed promise | Remaining operation and supported ship date | Purchasing and planning | Shipment or alternate-source evidence |
Suggested tracker: investigate the signal before deciding what it means for supply.
Combine related signals. A missed acknowledgement may be an overloaded order desk. A missed acknowledgement together with a credit hold at the casting source and a new prepayment demand creates a more concrete continuity concern. Record the chain of events and dates instead of summarizing it as “supplier looks weak.”
How should finance assess the supplier's position?
Finance should compare statements with current cash needs, debt obligations, receivables, and the cost of completing committed orders. Review trends and the legal entity that performs your work. Published accounts and third-party scores may lag the situation; use them as context for dated operational evidence, rather than letting one rating decide the purchase.
Request the most recent available annual statements and, for a critical dependency, current management information the supplier can reasonably share. Protect it through an NDA and restricted access. Explain the question: whether the supplier can purchase material, pay for outside processing, and complete the quantities already committed to you.
Ask who provides funding and whether it is available for this order. An announced investor is not the same as funds received. A profitable business can still have cash trapped in receivables or inventory. A loss-making business may have committed financing sufficient to fulfill your work. Finance should interpret those differences; buyers should record the resulting supply decision, not improvise financial conclusions.
Use consistent denominators and periods if finance calculates ratios. There is no universal current-ratio threshold that proves a supplier can ship your parts. Manufacturing cycle, customer concentration, group support, borrowing restrictions, and seasonal demand change the interpretation. Label estimates and unavailable figures clearly.
What should you ask the supplier to provide?
Ask for evidence tied to the threatened delivery: material availability, outside-processing release, production status, shipment authorization, and the person responsible for resolving the constraint. For a longer-term award, negotiate financial-information rights under confidentiality terms. Annual statements are a suggested contract condition for critical dependencies, not a legal duty imposed on every supplier.
Keep the initial request short enough to answer. “Please explain whether the credit hold affects PO 184's casting, who can release the material, and the earliest supported ship date” gives the supplier a task. “Complete our financial risk workbook” may delay the information needed for tomorrow's shortage meeting.
Escalate the conversation to an authorized finance or management contact if the issue concerns funding or payment. Do not ask an order-status contact to disclose confidential company accounts. If the supplier refuses information, record what remains unknown and decide whether the build exposure justifies an alternative source or additional protection.
For future sole-source or long-term awards, make reporting expectations explicit before negotiating the price: information to be shared, confidentiality, delivery dates, material-change notifications, and who receives them. Preserve those agreed rights with the contract so a later buyer can use them.
How do you protect builds without making an uncontrolled payment?
Compare the threatened delivery with usable stock and the time needed to obtain qualified replacement parts. Decide whether to support the current order, qualify another source, or do both. Any deposit, accelerated payment, or direct sub-tier payment needs finance and contract approval, with a defined purpose, evidence, and limit on exposure.
Avoid sending money merely because a supplier says it will help. Define what it buys: identified material, a released outside-processing lot, or a specific quantity shipped. Agree how progress will be verified and what happens if the promised milestone is missed. Check your own unpaid, undisputed invoices so your process is not creating the pressure you are trying to solve.
Keep the recovery clock realistic. A second supplier still needs drawings, tooling, process approval, production time, and any customer authorization. Start dual sourcing while the existing supplier continues work if that is the chosen mitigation. Expediting one shipment buys time; it does not remove the financial dependency.
In the United States
EO 14415 §7(c) links financial supply-chain risk to inability to meet financial obligations; its supplier-vetting provisions direct implementing regulations. Separately, a bankruptcy petition can trigger an automatic stay affecting acts to obtain possession of property from the estate. Tooling ownership does not establish immediate access. EO 14415, 11 U.S.C. 362(a)(3). Checked September 26, 2026.
Selling into the EU?
Tooling recovery depends on national insolvency and property rules. Germany's InsO §47 recognizes claims to separate items outside the estate. Spain's TRLC Article 239 addresses third-party property, subject to the debtor's use, security, or retention rights. Keep ownership and custody evidence, and have the recovery route checked before collection. InsO §47, TRLC Article 239. Checked September 26, 2026.
What records should you keep for customer-owned tooling?
Identify each tool by asset number, location, owner, condition, and the parts it makes. Keep purchase records, title provisions, photographs, custody acknowledgements, and any agreed access or transfer terms. These records support recovery planning, but a tag alone does not resolve competing rights or authorize removing an asset from a supplier's premises.
Include gauges, fixtures, programs, maintenance records, and technical data needed to use the tool elsewhere. Verify whether your ownership covers all of them. A die transferred without the information needed to run it may protect an asset while leaving the build stopped.
Do the inventory before a crisis. Ask the supplier to confirm the current location and condition, and reconcile that reply with your records. Have procurement and contract owners resolve missing terms while the relationship is operating normally. If financial distress escalates, coordinate any move through the people responsible for legal rights, customer approvals, quality, and production.
What belongs in a financial-risk action tracker?
Track the verified signal, affected entity and part, first exposed build, evidence date, finance decision, and next action. Keep payment approval separate from shipment confirmation. Close a mitigation when the agreed result exists, not when cash is transferred or a supplier promises improvement. Reassess if the next milestone fails.
Use this checklist in the review:
- Verify the signal through an authorized contact
- Identify orders, material, outside processes and builds affected
- Have finance review current evidence and gaps
- Confirm your own invoice and payment status
- Check usable inventory and qualified replacement lead time
- Inventory owned tooling and preserve the ownership records
- Approve any support with a purpose, limit, and milestone
- Assign a decision owner, follow-up date, and escalation trigger
- Save shipment or qualification evidence before closing the action
Keep these actions with the broader supplier risk assessment and supply chain risk management plan. Delivery changes still need the line-by-line discipline described in purchase order tracking.
What questions do teams ask about supplier financial risk?
Financial warning signals need context and a clear decision owner. Buyers can gather order evidence and identify exposed builds, while finance and contract specialists evaluate funding and rights. These answers explain how to treat prepayment requests, historical scores, and tooling recovery without drawing conclusions that the available evidence cannot support.
Does a prepayment request mean the supplier is failing?
No. Deposits can be normal for custom work, new relationships, or unusual material purchases. Check what changed and why, whether the request matches the contract, and what specific supply milestone it supports. Concern increases when the request appears alongside verified material holds, missed commitments, or an inability to explain funding for your order.
Should purchasing rely on a credit score?
A credit score is one input with a date and scope. Have finance interpret it alongside current statements and operational evidence for the entity supplying your parts. A favorable historical rating does not establish that this week's material purchase is funded; a weak rating does not tell you which build is exposed first.
Can we collect our tooling when the supplier files for bankruptcy?
Ownership evidence helps establish your position, but access, possession, court process, and competing rights still matter. Bring the contract, asset inventory, and location records to the people managing the recovery. Do not assume a tooling label or a paid invoice gives the buyer authority to arrive and remove it during insolvency proceedings.
If your team needs a clearer process for gathering supplier delivery evidence, talk to our team about the follow-up work behind your critical orders.
This article is general information, not legal or tax advice. Check how the rules apply to your business with your legal or tax advisor.
