Geopolitical supply risk: dated triggers and ownership checks
Turn official policy changes into part-level supply decisions with dated triggers, ownership checks and a practical supplier watchlist.
A country-risk score can flag exposure, but it cannot tell your planner which order to change today. Make geopolitical supply risk actionable by connecting each official change to a part, supplier, ownership chain, shipping route, and decision date. The result is a watchlist that tells the team when to act.
What is geopolitical supply risk?
Geopolitical supply risk is the possibility that government action, conflict, or political instability interrupts the materials, production, payments, or transport your build needs. Manage it by mapping exposed parts and routes, tracking dated official triggers, and assigning a response owner. A country rating alone cannot establish whether a particular order can ship.
Keep this topic distinct from the broader supplier risk assessment. The task here is to turn a change outside the supplier's control into a specific supply decision. An ownership change can be relevant even when the factory and its delivery performance remain unchanged.
The same method applies globally. The legal rule depends on the jurisdictions and transaction involved. A Chinese export restriction, a US end-user control, and an EU asset freeze are different checks; passing one does not settle the others. Use the Resilience module to connect these checks with your other supplier risks.
How do you map exposure to the parts that matter?
Start with the parts that can stop a build and trace the production and delivery route far enough to identify the relevant exposure. Record the manufacturing site, material source, processor, exporter, destination, and known owners. Mark missing information explicitly, then ask the supplier focused questions rather than sending an undirected country-risk questionnaire.
The invoicing address is a starting point, not the map. A domestic supplier may buy controlled material abroad. A distributor may invoice from one country while the goods ship from another. Ask where the part and its critical inputs originate, and which party is responsible for obtaining any required authorization.
Prioritize gaps by consequence and available response time. Unknown material origin for a build-gating component deserves investigation before a low-impact commodity's complete ownership chart. Record the evidence and its date so the next reviewer knows which facts are confirmed and which are supplier statements still awaiting support.
If two approved suppliers rely on the same country, processor, or transport corridor, they may share the same exposure. Check that independence as part of dual sourcing, and carry the dependency into supply concentration risk.
Which dated triggers belong on the watchlist?
Track the official instrument, the action it changes, its effective or expiry date, the exposed parts, and the last safe decision date. Include immediate changes such as a new designation or license denial. A scheduled review should happen early enough to qualify a source or change the build before the rule takes effect.

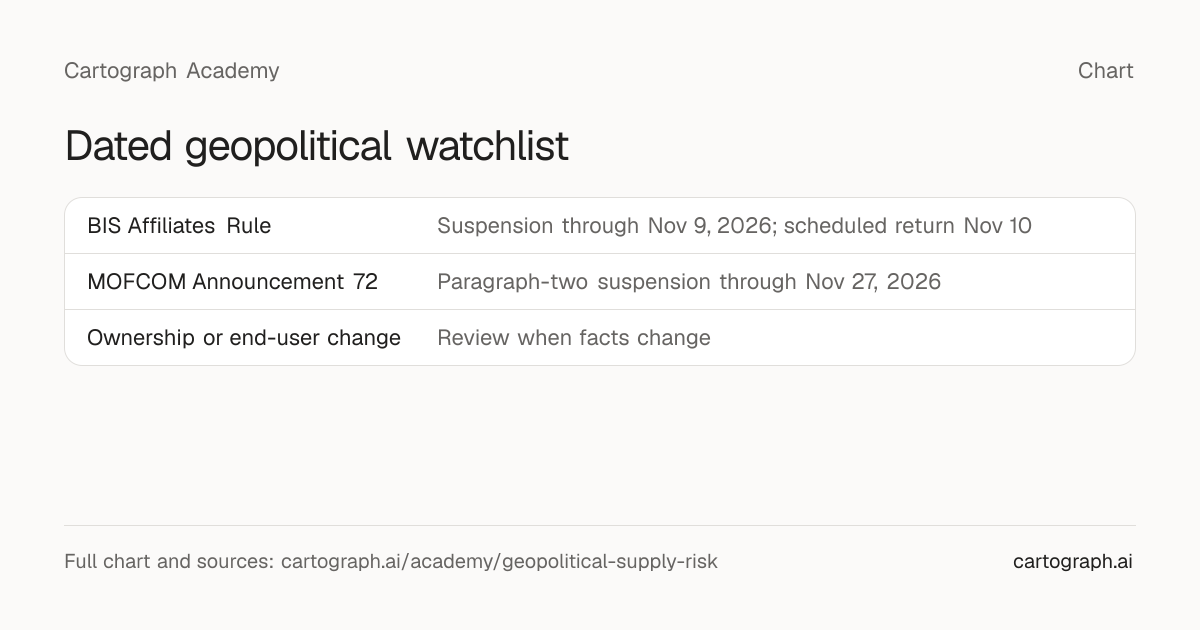

Dated geopolitical watchlist
A watchlist separates the BIS Affiliates Rule suspension ending November 9, 2026 from the MOFCOM paragraph-two suspension through November 27, 2026. It also identifies immediate ownership changes as a separate review trigger and lists the evidence each owner must obtain.
| Trigger | Official timing | Exposure to review | Evidence or action |
|---|---|---|---|
| BIS Affiliates Rule | Suspension through Nov 9, 2026; scheduled return Nov 10 | Applicable EAR transactions involving ownership-restricted entities | Recheck current rule and ownership assessment |
| MOFCOM Announcement 72 | Paragraph-two suspension through Nov 27, 2026 | Affected US-directed dual-use items and end use | Check item authorization and supported shipment |
| Ownership or end-user change | Review when facts change | Applicable sanctions or export-control transaction | Update structure and compliance disposition |
Official dates checked September 26, 2026; recheck for amendments before acting. Set an earlier internal decision date for each exposed part.
The dates in this lesson were checked on September 26, 2026. Treat scheduled changes as review triggers and verify the source again before acting; an extension or amendment can change the decision.
In the United States
BIS Affiliates Rule: the November 2025 rule suspends the expansion through November 9, 2026 and schedules its return on November 10, absent a further change. The expansion reaches entities at least 50% owned, directly or indirectly and individually or in aggregate, by specified listed or ownership-restricted entities. It concerns EAR end-user controls, not a universal prohibition on purchasing from every affected company. 90 FR 50857, sections I.A–C.
China's US-directed controls: Announcement 72 of 2025 suspends only paragraph two of Announcement 46 of 2024 through November 27, 2026. That paragraph addresses gallium-, germanium-, antimony-, and superhard-material-related dual-use exports and graphite reviews. Paragraph one's prohibition on dual-use exports to US military users or military uses remains separate. MOFCOM Announcement 72, Announcement 46.
A suspended destination restriction does not establish that a shipment needs no license. China's Dual-Use Export Control Regulations, article 14, retain licensing for listed and temporarily controlled items. Check the exact item and authorization rather than assuming that every material containing gallium, germanium, or antimony has identical treatment. State Council Decree 792, article 14.
Why should you screen ownership as well as names?
A supplier can be affected by restrictions without appearing under its own name on a screening list. Obtain and review ownership information using the rules applicable to the transaction, and escalate unresolved structures to your compliance owner. Preserve the reviewed structure and screening date so a later acquisition or divestment triggers a fresh check.
In the United States
OFAC's blocking rule is separate from the suspended BIS expansion. Entities owned 50% or more, directly or indirectly in aggregate, by one or more blocked persons are themselves considered blocked under OFAC's rule. Do not interpret the BIS suspension as suspending that ownership test. OFAC FAQ 402.
Selling into the EU?
EU asset-freeze checks also extend beyond listed names. EU guidance addresses ownership of 50% or more, aggregation of listed owners' interests, and control that can exist below that threshold. Apply the relevant regulation and assess the transaction with your compliance owner; a clean name search is incomplete evidence. EU Sanctions Helpdesk, ownership and control.
Use a supplier's legal identity, registration information, and dated ownership evidence. Similar names can create false matches; different names can hide the same owner. Keep the distinction between a screening alert, a verified relationship, and a compliance decision visible in the record.
Do not ask a buyer to clear a complex ownership structure based on one percentage in an email. Ask the designated compliance reviewer what evidence is sufficient and which transactions must pause while the facts are resolved. Continue operational recovery planning while that decision is made.
How do you turn a policy change into a supply decision?
Translate the official change into a practical question for each exposed order: can this item still move through this route, with this end user, under the required authorization, in time for the build? Assign compliance to decide permissibility and purchasing to confirm material availability, dates, and feasible alternatives under that decision.
Ask the supplier for the specific impacted items, current authorization status, application or renewal status where relevant, the quantity already available, and the earliest supported ship date. A statement that trade relations have improved is not evidence for a particular shipment.
Work backward from your need date. Include the time to qualify an alternative, obtain customer approval where required, produce the part, transport it, and complete receiving. If that sequence starts before an official expiry date, your sourcing decision cannot wait until the expiry.
Use the watchlist to support the supply chain risk management plan. Give each action an owner, due date, and closure evidence. “Monitor China” is too broad. “Confirm the authorization and delivery evidence for these named orders before the alternative-source decision date” creates a task someone can complete.
What should your team record after each review?
Keep a dated decision record linking the official source to the impacted parts, orders, evidence, and approved response. Record both the next check date and the event that would reopen the assessment earlier. This lets a new team member understand why the order continued, changed source, or moved in the schedule.
Copy this operating template into your risk register:
| Field | What to record |
|---|---|
| Exposure | Part, material, site, route and ownership relationship |
| Official trigger | Instrument, section, source URL and checked date |
| Timing | Effective date, expiry date and last safe action date |
| Transaction facts | Exporter, destination, end user and required authorization |
| Evidence gap | Missing document or fact, responsible party and due date |
| Decision | Compliance disposition and approved operational response |
| Recovery | Alternative route, qualification status and supported ship date |
| Reopen trigger | New designation, ownership change, denial or rule amendment |
Keep completed checks as historical records rather than overwriting them. A changed owner, new end user, or rerouted shipment can invalidate yesterday's conclusion. Avoid marking a risk closed just because the watchlist date moved; close the specific action when its evidence is complete.
What questions do teams ask about geopolitical supply risk?
Teams usually need to distinguish general exposure from an immediate shipment problem. Start with the actual part and transaction, establish the applicable rule, and ask what evidence supports delivery. When the facts are incomplete, assign the missing-information task and a decision deadline instead of presenting a country score as clearance.
Does a clean screening result mean the supplier is safe to use?
It is one input. Ownership, control, item restrictions, end use, and the actual transaction can require separate review. Keep the evidence and the compliance decision together.
Should every exposed part be resourced immediately?
No. Compare the impact, existing usable inventory, alternative qualification time, and supported delivery evidence. Choose a proportionate response before the last safe decision date.
Does the November 27 suspension cover every Chinese export control?
No. Announcement 72 suspends the specified paragraph of Announcement 46. Review the exact item and other applicable controls instead of treating the date as a general trade clearance.
Who owns the watchlist?
Give a named supply chain owner responsibility for the operating record and a compliance owner responsibility for legal applicability. Buyers confirm the affected orders and supplier evidence; planners translate the result into build decisions.
